Capability Check
The capability check is an order delivery estimate based upon an organization's constraints. It is an
advanced order promising engine which primarily verifies whether a requested delivery date for a customer order or
sales quotation line can be fulfilled or not. If the requested delivery date cannot be fulfilled, a new possible
delivery date is calculated. The capability check considers available stock and open supplies, and optionally the
available capacity after deducting already planned workload on finite work centers and labor classes. It handles
both single and multi-level product structures as well as single and multi-site setups.
The capability check is not just a check; optionally it enables saving interim orders to hold material as well
as capacity. This way, the chances of fulfilling the delivery date as planned increase significantly.
The capability check is primarily designed for make-to-order and configure-to-order operations.
Settings Affecting the Capability Check
The following settings impact how capability check runs when it is started automatically:
-
Capability Check on Inventory Part/Main tab: Controls whether a
capability check should be performed automatically. Depending on selected option, capability check can reserve
available stock and save interim orders to prevent another capability check to use same material and capacity.
For more information, see Start Capability Check, Reserving and Allocating an Interim Order and Saving Outcome.
-
Include Only Firm Demands on Inventory
Part/Manufacturing tab: Controls whether only firm
demands or all demands should be considered during the netting procedure within the capability check. Firm
demands are typically customer order lines, shop order materials and demands created by capability check.
Non-firm demands are typically MRP planned demands and MS unconsumed forecasts. For more information, see
Netting an Interim Order.
-
Include Only Firm Supplies on Inventory
Part/Manufacturing tab: Controls whether only firm supplies or all
supplies should be considered during the netting procedure within the capability check. Firm supplies are
typically purchase order lines, shop orders and supplies created by capability check. Non-firm supplies are
typically purchase requisition lines and shop order requisitions. For more information, see Netting an Interim Order.
-
Optimize New Delivery Date on Inventory Part/Manufacturing
tab: Controls whether an optimized new delivery date should be calculated in case the requested delivery date
could not be fulfilled by considering open supplies which become available for interim orders when they are
planned with later Scheduled Supply Dates. By considering these open supplies, larger
quantities of the interim orders can be netted and that might decrease the time it takes to
manufacture/purchase the interim orders. If Schedule and Create Load for Interim Order
Operations is enabled on the site, this setting can also be used to control whether the new delivery
date that should be calculated considering that child interim orders can be planned to match the start of the
operation on the parent interim order they are connected to. For more information, see Planning Step 4: Iterated Backwards Planning.
- Run in Background on Inventory Part/Manufacturing tab:
Controls whether the capability check should run as a background job instead of online.
-
Run MRP on Inventory Part/Manufacturing
tab: Controls whether a selective MRP (or project MRP) should run as a background job for the demanded part
when the capability check is done to create allocations for the parts in the structure which are planned to
stock. These created allocations are non-firm supplies and demands and will be considered in future capability
checks to ensure the same available stock and open supplies are not netted again when Include Only Firm
Demands and Include Only Firm Supplies are disabled. For more information, see
Saving Outcome.
Note: A selective project MRP is run for the demanded part instead of a selective MRP if the source line is
connected to a project activity. The selective project MRP will be followed by selective MRPs if parts which
are not project planned exist in the structure.
-
Run CRP on Inventory Part/Manufacturing tab: Controls
whether CRP should run integrated with the selective MRP (or project MRP) to book machine and/or labor capacity
for the parts in the structure which are planned to stock and ensure the same capacity is not used by another
capability check in the future. For more information, see Saving Outcome.
The following settings impact how capability check runs and are set when it is started manually using the
Capability Check dialog:
-
Reservation and Allocation Options: Controls whether available stock should be reserved or not
and whether interim orders should be saved to prevent another capability check to use the same material and
capacity. For more information, see Reserving and
Allocating an Interim Order and Saving Outcome.
- Include Only Firm Demands: Same impact as Include Only Firm Demands has
when automatically starting capability check.
- Include Only Firm Supplies: Same impact as Include Only Firm Supplies has
when automatically starting capability check.
- Optimize New Delivery Date: Same impact as Optimize New Delivery Date has
when automatically starting capability check.
- Run in Background: Same impact as Run in Background has when automatically
starting capability check.
- Run MRP: Same impact as Run MRP has when automatically starting capability
check.
- Run CRP: Same impact as Run CRP has when automatically starting capability
check.
The following settings also have an impact of how the capability check runs, both when it is started
automatically and manually:
-
Promise Planned on Inventory Part/Manufacturing, Product
Structure/Components, Configuration Structure/Components and
Recipe Structure/Components tab: Controls which parts that should be included in the
capability check. For more information, see Building an
Interim Order Structure.
-
Supply Code on Customer Order/Lines or Sales
Quotation/Lines tab: Controls which Reservation and Allocation Options the
capability check can be performed with (see Start Capability Check), how
the netting is performed (see Netting an Interim Order) and how interim
orders in the interim structure are discarded (see Saving Outcome).
-
Release for Mtrl Planning on Customer Order/Lines: Controls which
Reservation and Allocation Options the capability check can be performed with (see Start Capability Check).
-
Release for Planning on Sales Quotation/Lines: Controls which
Reservation and Allocation Options the capability check can be performed with (see Start Capability Check).
-
Sourcing Option on Sales Part/General/Sourcing page: Controls how
the netting is performed (see Netting an Interim Order) and how interim
orders in the interim structure are discarded (see Saving Outcome) when several
sites are used to supply the demand on the capability check source.
-
DOP Netting on Inventory/Main tab: Impacts the netting process. For
more information, see Netting an Interim Order.
-
Default Supply Type on Inventory Part Planning Data/General/Part Planning
Info tab: Impacts the netting process. For more information, see Netting an Interim Order.
-
Consumption Item on Product Structure/Components,
Configuration Structure/Components and Recipe
Structure/Components tab: Controls how the netting is performed. For more information, see
Netting an Interim Order.
-
Std Planned Item on Product
Structure/Components tab: Impacts how interim orders are netted,
allocated and reserved when the source customer order line is connected to a project activity. For more
information, see Netting an Interim Order and Reserving and Allocating an Interim Order.
-
Schedule and Create Load for Interim Order Operations on
Site/Manufacturing tab: Controls how interim orders for manufactured parts should be
planned and scheduled. For more information, see Planning Step
1: Backwards Planning, Planning Step 3: Backwards
Planning, Planning Step 4: Iterated Backwards
Planning, Planning an Interim Order and Scheduling Interim Order Operations.
-
Finite Capacity on Work Center and Manufacturing Labor
Class pages: Controls whether interim orders should schedule operations only when available
capacity exists after deducting existing load. For more information, see Scheduling Interim Order Operations.
-
Load Sources to Consider in Finite Loading on Site/Manufacturing
tab: Controls which types of existing load that should be considered when scheduling an interim order operation
on a finite work center or labor class. For more information, see Scheduling Interim Order Operations.
Note: It is only recommended to enable Run MRP and Run CRP if it is necessary
to create allocations and book capacity for parts in the structure which are planned to stock immediately after the
capability check is done to prevent another capability check to use same material and capacity. It can have a
negative impact on the performance of the application and also interfere with the material and production planning
processes since requisitions and load for requisitions can change at unpredictable times. If appropriate schedule
MRP to run, perhaps integrated with CRP, at specific times instead of after each capability check.
To run the capability check, the below prerequisites must be fulfilled:
- The customer order must not be released and the sales quotation must not be won/lost.
- If the part is configurable, it must have been configured.
- To run capability check from Customer Order or Sales
Quotation, the supply code must be Shop Order, DOP Order,
Invent Order, Int Purch Trans or Int Purch Dir. If the supply
code is Int Purch Trans or Int Purch Dir the sourcing option on the sales part
at the supply site must be Shop Order, Inventory Order or DOP
Order, and for sourcing option Shop Order the part must be of part type
Manufactured.
- Manufactured parts are required to have buildable structures and routings.
- The part type must not be Remanufactured, Disassembly Component,
By-Product, Co-Product or Core.
- It is recommended to have Availability Check disabled on the Inventory
Part/Main tab.
- If Schedule and Create Load for Interim Order Operations has been enabled for the site, the
work centers must have a resource that is valid within the entire evaluated date range.
The capability check can be started either automatically or manually. If the inventory part linked to the sales
part has Capability Check set to either Reserve and Allocate, Allocate
only or Neither Reserve nor Allocate, the capability check is automatically started with
the selected reservation and allocation option when a new customer order line with supply code DOP
Order, Shop Order, Int Purch Trans or Int Purch Dir is
saved, or an existing line is edited. The other capability check related settings on Inventory
Part/Manufacturing also impact how the capability check runs when it is
started automatically. Capability check cannot be run automatically for a sales quotation line.
If Capability Check is set to No Automatic Capability Check, you must manually
start the capability check by selecting the relevant customer or sales quotation line, click Capability
Check and then Run Capability Check. Before clicking OK in the
Capability Check dialog, define the appropriate settings in the Options
section:
-
Reservation and Allocation Options: Select the appropriate type of reservation and allocation
option to use for the capability check in the drop-down. The different options are:
- Reserve and Allocate: Available when supply code is set to DOP Order
and the customer order line has Release for Mtrl Planning enabled, or the sales quotation is
in Released or Revised status and has Release for Planning
enabled.
- Allocate only: Available when supply code is set to either DOP Order or
Shop Order and the customer order line has Release for Mtrl Planning
enabled, or the sales quotation is in Released or Revised status and has
Release for Planning enabled. Also available when supply code is set to either Int
Purch Trans or Int Purch Dir, the sourcing option for the sales part at the supply
site is DOP Order or Shop Order, the customer order line has
Release for Mtrl Planning enabled, or the sales quotation is in Released or
Revised status and has Release for Planning enabled.
- Neither Reserve nor Allocate: Available when supply code is set to either DOP
Order, Shop Order, Invent Order, Int Purch Trans
or Int Purch Dir.
- Include Only Firm Demands: Enable Include Only Firm Demands if you only
want firm demands instead of all demands to be considered during the netting procedure in the capability
check.
- Include Only Firm Supplies: Enable Include Only Firm Supplies if you only
want firm supplies instead of all supplies to be considered during the netting procedure in the capability
check.
- Optimize New Delivery Date: Enable Optimize New Delivery Date if you want
to optimize the new delivery date that is calculated in case the requested delivery date could not be fulfilled
by considering open supplies which become available for interim orders when they are planned with later
Scheduled Supply Dates. If Schedule and Create Load for Interim Order
Operations is enabled on the site, also enable this setting if you want the new delivery date that is
generated when the requested delivery date is not possible to fulfill to be calculated considering that child
interim orders can be planned to match the start of the operation on the parent interim order they are connected
to.
- Run in Background: Enable Run in Background if you want the capability
check to run as a background job instead of online.
-
Run MRP: Enable Run MRP if you want a selective MRP (or project MRP) to be
triggered as a background job for the demanded part when the capability check is done to create allocations for
the parts in the structure which are planned to stock. These created allocations are non-firm supplies and
demands and will be considered in future capability checks to ensure the same available stock and open supplies
are not netted again when Include Only Firm Demands and Include Only Firm
Supplies are disabled. It is only possible to enable Run MRP:
- If Reservation and Allocation Options is set to either Reserve and
Allocate or Allocate only.
- If the supply code is Invent Order and Release for
Planning/Release for Mtrl Planning is enabled for the source sales
quotation/customer order line. In case the source is a sales quotation line, the status of the sales
quotation must be Released or Revised.
- If the supply code is Int Purch Trans or Int Purch Dir, Release
for Planning/Release for Mtrl Planning is enabled for the source sales
quotation/customer order line and the sourcing option for the sales part at the supply site is
Inventory Order. In case the source is a sales quotation line, the status of the sales
quotation must be Released or Revised.
Note: A selective project MRP is run for the demanded part instead of a selective MRP if the source line
is connected to a project activity. The selective project MRP will be followed by selective MRPs if parts which
are not project planned exist in the structure.
- Run CRP: Enable Run CRP if you want a CRP to run integrated with the
selective MRP (or project MRP). The CRP will book machine and/or labor capacity for the parts in the structure
which are planned to stock and ensure the same capacity is not used by another capability check in the future. It
is only possible to enable Run CRP when Run MRP is enabled.
Capability Check Algorithm
The capability check consists of three different phases, an initial phase, a planning phase and a final phase.
It uses an interim order structure that is built in the initial phase. The planning phase includes four planning
steps, but all steps are not executed in each capability check. The first planning step is always executed. It
contains a netting procedure and evaluates if the requested delivery date on the source customer order/sales
quotation line can be fulfilled or not. If the requested delivery date can be fulfilled, all other planning steps
are skipped. Else the second planning step is executed followed by either the third planning step or the fourth
planning step, depending on the Optimize New Delivery Date setting. The purpose of the second
planning step is to calculate a completion date that is possible to fulfill. If Optimize New Delivery
Date is disabled, the third planning step is used to reschedule the interim order structure based on the
possible completion date that was calculated. If Optimize New Delivery Date is enabled, the fourth
planning step is used to calculate an optimized completion date, which might be earlier than the possible
completion date, and to schedule the interim order structure based on this optimized completion date. When the
planning phase of the capability check is done, the outcome is saved in the final phase. If the requested delivery
date was not possible to fulfill, a new delivery date will be set on the source line based on the possible
completion date (if Optimize New Delivery Date is disabled) or the optimized completion date (if
Optimize New Delivery Date is disabled).

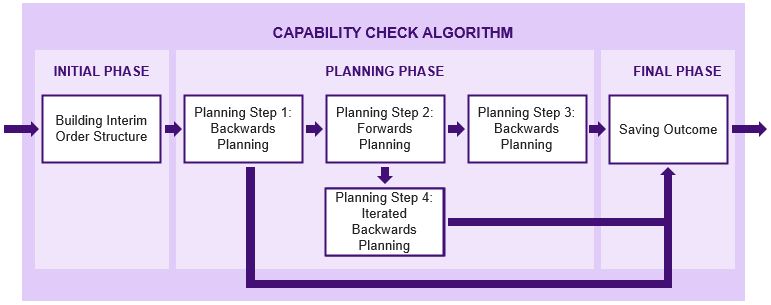

In the picture below, the different phases of the capability check algorithm are visualized.

The sections below describe how the interim order structure that is used in the capability check is built, what
happens in each of the four planning steps and how the outcome of the capability check is saved. In addition,
detailed information about how the Create Pegged Orders at Release field is set for an interim
order, how an interim order is netted, how an interim order is reserved and allocated, how an interim order is
planned and how interim order operations are scheduled is given.

The capability check starts with building an interim order structure for the source customer order or sales
quotation line if no interim order structure that is possible to use already exists. The Required
Date on the topmost interim order header will be set to the planned due date needed to fulfill the
requested delivery date on the source line. For a non-configured part, the manufacturing structures and routings
are used. For a configured part, the configuration attributes specified for the source line along with the
part’s configured structures and routings are used. The revision used, is the valid revision for the supply
date on the current interim order.
The interim order structure is created with all parts at all levels and sites. However, an exception occurs in
case a component part to an interim order in the structure has Promise Planned set to Not
Promised. Then the interim order for that component part is created without any components and operations.
If there are component parts supplied by another site, a separate interim order structure is built at the primary
supplier site. An interim order structure at a supply site becomes a child to an interim order structure at a
demand site.
Exception: When the supply code of the source line is Int Purch Dir, the Required
Date on the topmost interim order header will be set differently. The topmost interim order header will be
created at the demand site and contain one interim order. The Required Date for this interim order
header will be set equal to the planned delivery date on the source line instead of the planned due date. In this
way, the Required Date of the interim order header at the supply site will become equal to the
supply site due date on the source line.
If you have created an interim order structure for the source line before running the capability check
(typically for a configured part) and no component parts are supplied by another site, the capability check will
use this interim order structure, including changes, instead of creating a new. If you are running capability check
repeatedly times for the same line, an already existing interim order structure will always be deleted and replaced
with a new interim order structure. This means that if you modify an existing interim order structure after running
the capability check, and then re-run the capability check, all your changes will be lost.
Before continuing to the planning phase of the capability check, the Create Pegged Orders at
Release field is set for each interim order in the structure depending on whether pegged supply orders
will be created for the interim order part when the connected customer order is released. For more information, see
Setting Field Create Pegged Orders at
Release for Interim Order.

The first planning step in the capability check evaluates if the requested delivery date can be fulfilled or
not. Starting with the topmost interim order, the interim orders are netted and planned backwards down in the
interim order structure from the planned due date needed to fulfill the requested delivery date. This date is the
same as the Required Date on the topmost interim order header.
For each interim order in the interim order structure, starting with the topmost interim order, and then going
downwards level by level, starting with the interim order with the lowest ID on each level, the following steps are
done:
- The Scheduled Supply Date is set as follows:
- For the topmost interim order, the Scheduled Supply Date is set to the Required
Date on the topmost interim order header.
- For a child interim order, how the Scheduled Supply Date is set varies:
- If Schedule and Create Load for Interim Order Operations is disabled for the site:
- If the child interim order has no lead time offset, the Scheduled Supply Date is
set to the same date as the Scheduled Start Date of the parent interim order.
- If the child interim order has a lead time offset, the Scheduled Supply Date is
set to the lead time offset number of days before the Scheduled Supply Date of the
parent interim order, but not earlier than the Scheduled Start Date of the parent
interim order.
- If Schedule and Create Load for Interim Order Operations is enabled for the site:
- If the child interim order is connected to an operation on the parent interim order, the
Scheduled Supply Date is set to the Scheduled Start Date/Time of
that operation minus the queue time of the work center of the operation or, if that date is not a
working day according to the site manufacturing calendar, the previous workday.
- If the child interim order is not connected to any operation on the parent interim order, the
Scheduled Supply Date is set in the same way as when Schedule and Create
Load for Interim Order Operations is disabled.
- Netting is done against available stock and open supplies available up to and including the Scheduled
Supply Date. Net Qty is set to the quantity that remains to be supplied. If a quantity
is netted, adjusted quantities are propagated downwards to child interim orders. For more information, see
Netting an Interim Order. Depending on the selected Reservation
and Allocation Options, reservations and allocations are made. For more information, see Reserving and Allocating an Interim Order.
- The Scheduled Start Date is set by backwards planning the interim order from the
Scheduled Supply Date. For more information, see Planning
an Interim Order.
- The Start Date is set to the same date as the Scheduled Start Date and the
Supply Date is set to the same date as the Scheduled Supply Date.
If all leaf nodes in the interim order structure have a Start Date that is not earlier than the
first workday after today’s date according to the site manufacturing calendar, it means that the requested
delivery date can be fulfilled, and the planning part of the capability check is done. Else, the capability check
continues with the second planning step followed by either planning step three or four.
Planning Step 2: Forwards Planning

The second planning step in the capability check is done when the requested delivery date cannot be fulfilled
and calculates a completion date that is possible to fulfill. Starting with the lowest level interim orders with
Net Quantity > 0, the interim orders are planned forwards up in the interim order structure
from the first workday after today’s date according to the site manufacturing calendar.
For each interim order in the interim order structure with Net Quantity > 0, starting with
the lowest level interim orders and then going upwards level by level, starting with the earliest interim order on
each level, the following steps are done:
- The Scheduled Start Date is set as follows:
- For the lowest level interim orders with Net Quantity > 0, the Scheduled
Start Date is set to the first workday after today’s date.
- For a parent interim order, the Scheduled Start Date is set to the latest
Scheduled Supply Date of its child orders.
- The Scheduled Supply Date is set by forwards planning the interim order from the
Scheduled Start Date. For more information, see Planning an
Interim Order.
The result after this step is a possible completion date, that is the same date as the Scheduled Supply
Date on the topmost interim order. This date will be later than the Required Date on the
topmost interim order header.

The third planning step is done after the second planning step when Optimize New Delivery Date
is disabled. It schedules the interim order structure based on the possible completion date that was calculated in
the second planning step.
For each interim order in the interim order structure, starting with the topmost interim order, and then going
downwards level by level, starting with the interim order with the lowest ID on each level, the following steps are
done:
- The Scheduled Supply Date is set as follows:
- For the topmost interim order, the Scheduled Supply Date is set to the possible
completion date.
- For a child interim order, how the Scheduled Supply Date is set varies:
- If Schedule and Create Load for Interim Order Operations is disabled for the site:
- If the child interim order has no lead time offset, the Scheduled Supply Date is
set to the same date as the Scheduled Start Date of the parent interim order.
- If the child interim order has a lead time offset, the Scheduled Supply Date is
set to the lead time offset number of days before the Scheduled Supply Date of the
parent interim order, but not earlier than the Scheduled Start Date of the parent
interim order.
- If Schedule and Create Load for Interim Order Operations is enabled for the site:
- If the child interim order is connected to an operation on the parent interim order, the
Scheduled Supply Date is set to the Scheduled Start Date/Time of
that operation minus the queue time of the work center of the operation or, if that date is not a
working day according to the site manufacturing calendar, the previous workday.
- If the child interim order is not connected to any operation on the parent interim order, the
Scheduled Supply Date is set in the same way as when Schedule and Create
Load for Interim Order Operations is disabled.
- The Scheduled Start Date is set by backwards planning the interim order from the
Scheduled Supply Date. For more information, see Planning
an Interim Order.

The fourth planning step is done after the second planning step when Optimize New Delivery Date
is disabled. It calculates an optimized completion date and schedules the interim order structure based on this
optimized completion date. The optimized completion date will be later than the Required Date on
the topmost interim order header and earlier than or equal to the possible completion date that was calculated in
the second planning step. In order to find which date within this date interval that is the optimized completion
date a backwards planning and netting procedure of the interim order structure, similar to the first planning step,
is iterated from different dates within the interval until the optimized completion date has been found. By doing
so, open supplies which become available for interim orders when they are planned with later Scheduled
Supply Dates than used in the first planning step are considered. Larger quantities of the interim orders
can be netted and that might decrease the time it takes to manufacture/purchase the interim orders.
The optimized completion date will be the earliest iterated date for which the backwards planning and netting
procedure results in Scheduled Start Dates equal to or later than the first workday after
today’s date according to the site manufacturing calendar for all interim orders in the structure. If the
last iterated date is not equal to the optimized completion date, an additional iteration is done from the
optimized completion date to redo the netting and reschedule the interim order structure based on the optimized
completion date. Depending on the selected Reservation and Allocation Options, reservations and
allocations are made before the fourth planning step ends. For more information, see Reserving and Allocating an Interim Order.
The next iteration date is set using the split half method for the date interval. This means the next iteration
date is set to the date between the start date and the end date of the interval. Before the first iteration, the
start date of the interval will be equal to the Required Date on the topmost interim order header
and the end date of the interval will be equal to the possible completion date. If no date between the start date
and the end date of the interval exists, the optimized completion date has been found. It will be equal to the
current end date of the interval.
In each iteration the following procedure is executed. For each interim order in the interim order structure,
starting with the topmost interim order, and then going downwards level by level, starting with the interim order
with the lowest ID on each level, the following steps are done:
- The Scheduled Supply Date is set as follows:
- For the topmost interim order, the Scheduled Supply Date is set to the current iteration
date.
- For a child interim order, how the Scheduled Supply Date is set varies:
- If Schedule and Create Load for Interim Order Operations is disabled for the site:
- If the child interim order has no lead time offset, the Scheduled Supply Date is
set to the same date as the Scheduled Start Date of the parent interim order.
- If the child interim order has a lead time offset, the Scheduled Supply Date is
set to the lead time offset number of days before the Scheduled Supply Date of the
parent interim order, but not earlier than the Scheduled Start Date of the parent
interim order.
- If Schedule and Create Load for Interim Order Operations is enabled for the site:
- If the child interim order is connected to an operation on the parent interim order, the
Scheduled Supply Date is set to the Scheduled Start Date/Time of
that operation minus the queue time of the work center of the operation or, if that date is not a
working day according to the site manufacturing calendar, the previous workday.
- If the child interim order is not connected to any operation on the parent interim order, the
Scheduled Supply Date is set in the same way as when Schedule and Create
Load for Interim Order Operations is disabled.
- Netting is done against available stock and open supplies available up to and including the Scheduled
Supply Date. Net Qty is set to the quantity that remains to be supplied. If a quantity
is netted, adjusted quantities are propagated downwards to child interim orders. For more information, see
Netting an Interim Order.
- The Scheduled Start Date is set by backwards planning the interim order from the
Scheduled Supply Date. For more information, see Planning
an Interim Order.
Before finishing the current iteration the interval is split in half. If all leaf nodes in the interim order
structure have a Scheduled Start Date that is not earlier than the first workday after
today’s date according to the site manufacturing calendar, the current iteration date is possible to fulfill,
and an even earlier date might be possible to fulfill. Then the end date of the interval is updated to the current
iteration date. Else, the current iteration date is not possible to fulfill, but a later date will be. Then the
start date of the interval is updated to the current iteration date.

When the planning phase is finished, the outcome from the capability check is saved as a capability check
result. Information created during the capability check about the interim orders in the interim order structure is
saved to the database. However, some or all of the actual interim orders that were created might be deleted or
partly discarded. If the Reservation and Allocation Options specified when running the capability
check is:
- Neither Reserve nor Allocate: All the interim orders are deleted and their allocations and
load are discarded. Only the topmost interim order header is saved.
-
Reserve and Allocate or Allocate only: Interim orders for parts for which
pegged supply orders will be created when the customer order is released and their component interim orders are
saved. This means the interim orders with Create Pegged Orders at Release set to
Yes and their component interim orders are saved. All other interim orders are deleted. The
saved component interim orders for parts for which pegged supply orders will not be created when the customer
order is released have Create Pegged Orders at Release set to No and will be
partly discarded. Only their interim order demands are kept. Their components, component work guidelines,
operations, operation work guidelines and tools are discarded. Also their interim order supplies and load are
discarded. They will have no reservations. For more information, regarding how the Create Pegged Orders
at Release field is set see Setting Field Create Pegged Orders at
Release for Interim Order.
The picture below displays an example of which interim orders in the structure that are saved in case the supply
code of the source line is DOP Order and the Reservation and Allocation Options
is Reserve and Allocate or Allocate only. All interim orders with parts which are
planned to order and have default supply type set do DOP have Create Pegged Orders at
Release set to Yes. These interim orders and their component interim orders are saved.
The saved interim orders which are planned to stock and have another default supply type than DOP
have Create Pegged Orders at Release set to No. For these interim orders only the
interim order demands are kept.

The saved interim orders hold reservations and allocations of available material and, in case Schedule
and Create Load for Interim Order Operations is enabled for the site and load not discarded, also
available capacity through the generated workload. That prevents future capability checks to net from the same
stock and open supplies and schedule operations using the same capacity as already used by these interim orders.
Since no interim order allocations of available material or available capacity are hold for the deleted interim
orders, a risk is that future capability checks net from the same stock and open supplies and schedule operations
using the same capacity as already used by these deleted interim orders. However, running MRP and CRP after the
current capability check and disabling Include Only Firm Demands in future capability checks will
prevent that from happening.
If capability check was started with Run MRP enabled, a background job for running a selective
MRP (or project MRP) for the demanded part is triggered to create allocations for the parts in the structure which
are planned to stock. In case there are component parts supplied by another site, selective MRP will also run for
these component parts at the supplying site. In case the demanded part is master scheduled, master scheduling will
run for the specific part before the selective MRP (or project MRP) is started. This is done to make sure the
demand from the source line consumes the master schedule forecast demand before MRP runs and hence, avoid
calculating with double demands.
Note: A selective project MRP is run for the demanded part instead of a selective MRP if the source line is
connected to a project activity. In case the structure contains component parts at the primary demand site which
are not project planned, the selective project MRP will be followed by selective MRP for these parts. In case there
are component parts supplied by another site, selective MRP will run for these component parts at the supplying
site.
If also Run CRP was enabled when starting the capability check, CRP will run integrated with
the selective MRP (or project MRP) and book machine and/or labor capacity for the parts in the structure which are
planned to stock in the same background job.
The source customer order or sales quotation line is updated. If the requested delivery date is not possible to
fulfill, the Scheduled Supply Date on the topmost interim order in the interim order structure is
used to set the new Planned Due Date on the source line. If Optimize New Delivery
Date is disabled, this Scheduled Supply Date will be the same as the possible completion
date that was calculated in the second planning step. Else, the date will be equal to the optimized completion date
that was calculated in the fourth planning step. Other dates on the line, e.g., the Planned Delivery
Date/Time, are calculated forwards based on this new Planned Due Date. The earliest
Scheduled Start Date in the interim structure will be set as the Latest Release
Date on the source line. This is the date when manufacturing must start, or the first part must be
purchased.
Exception: When the supply code of the source line is Int Purch Dir, the Scheduled
Supply Date on the topmost interim order minus the External Transport Lead Time defined
between the primary supply site and the customer is used to set the new Planned Due Date on the
source line. In this way, the supply site due date on the source line will become equal to the Scheduled
Supply Date of the topmost interim order at the supply site (belonging to the second interim order
header).
The capability check will finally give you a message if the delivery date is changed. Otherwise, you are simply
informed that the delivery date can be fulfilled as planned.

Before finishing the build interim order structure step, the Create Pegged Orders at Release
field is set for each interim order in the structure. The field is set to Yes for the interim
orders for parts for which pegged supply orders will be created when the customer order is released. For the other
interim orders for parts for which pegged supply orders will not be created, the field is set to
No. How to set the field is depending on different settings. Also whether the interim order
belongs to the topmost header or to another header at a lower level in the interim order structure impacts.
- For an interim order belonging to the topmost header, Create Pegged Orders at Release is set
depending on the supply code of the source customer order or sales quotation line. If the supply code is:
-
DOP Order:
- If the interim order is the topmost interim order: Create Pegged Orders at Release
is set to Yes.
- Else if the parent interim order has Create Pegged Orders at Release set to
Yes and the interim order part has Default Supply Type set to
DOP and/or is configurable: Create Pegged Orders at Release is set to
Yes.
- Else: Create Pegged Orders at Release is set to No.
-
Shop Order:
- If the interim order is the topmost interim order: Create Pegged Orders at Release
is set to Yes.
- Else: Create Pegged Orders at Release is set to No.
-
Invent Order:
- Create Pegged Orders at Release is set to No.
-
Int Purch Trans:
- Create Pegged Orders at Release is set to Yes.
-
Int Purch Dir:
- Create Pegged Orders at Release is set to Yes.
- For an interim order belonging to another header at a lower level in the structure, Create Pegged
Orders at Release is set depending on the sourcing option of the sales part connected to the inventory
part on the topmost interim order for the specific header. If the sourcing option is:
-
DOP Order:
- If the parent interim order has Create Pegged Orders at Release set to
Yes and the interim order part has Default Supply Type set to
DOP and/or is configurable: Create Pegged Orders at Release is set to
Yes.
- Else: Create Pegged Orders at Release is set to No.
-
Shop Order:
- If the parent interim order has Create Pegged Orders at Release set to
Yes and the interim order is the topmost interim order for the specific header:
Create Pegged Orders at Release is set to Yes.
- Else: Create Pegged Orders at Release is set to No.
-
Inventory Order:
- Create Pegged Orders at Release is set to No.
- Neither DOP Order, Shop Order nor Inventory Order:
- Create Pegged Orders at Release is set to No.

During the first and fourth planning steps in the capability check, netting is done for each interim order in
the interim order structure that is supposed to be netted and have Promise Planned set to
Promised. Additionally, for a component DOP order to be netted, it must have Consumption
Item set to Consumed. Which interim orders to net are decided based on different
settings. Also, whether the interim orders belong to the topmost header or to another header at a lower level in
the interim order structure impacts.
- For the interim orders belonging to the topmost header, netting is dependent on the supply code of the source
customer order/sales quotation line. If the supply code is:
- DOP Order: All interim orders belonging to the specific header with parts with another
default supply type than DOP are netted. If the topmost interim order for the header is for
a part with DOP netting set to Netting or Auto Netting also the interim
orders for parts with default supply type set to DOP are netted if the parts have DOP
netting set to Netting or Auto Netting.
Exception: If the topmost interim order is for a part with another default supply type than
DOP, the topmost interim order is only netted if the part has DOP netting set to
Netting or Auto Netting.
- Shop Order: All interim orders belonging to the specific header except for the topmost
interim order are netted.
- Invent Order: All interim orders belonging to the specific header are netted.
- Int Purch Trans: No interim order belonging to the specific header is netted.
- Int Purch Dir: No interim order belonging to the specific header is netted.
- For interim orders belonging to another header at a lower level in the structure, netting is dependent on the
sourcing option of the sales part connected to the inventory part on the topmost interim order for the specific
header. If the sourcing option is:
- DOP Order: See when the supply code is DOP Order.
- Shop Order: See when the supply code is Shop Order.
- Inventory Order: See when the supply code is Invent Order.
- Neither DOP Order, Shop Order nor Invent Order: No
interim order belonging to the specific header is netted.
Note: Interim orders with Promise Planned set to Not Promised are never
netted. Interim orders with Consumption Item set to Not Consumed are also not
netted, as they are not consumed in the material issue process, and their Net Qty will be set to
0.
Netting of an interim order is done against available stock and open supplies available up to and including the
Supply Date of the interim order, without driving the projected quantity negative within the
cumulative lead time for manufactured parts and within the expected lead time for purchased parts. The netting
occurs after the Scheduled Supply Date (used to set the Supply Date) of the
interim order has been calculated but before calculating the Scheduled Start Date (used to set the
Start Date).The netting procedure starts by analyzing available quantity in three different
calculations:
The netting procedure starts by analyzing available quantity in three different calculations:
- Calculation 1: Available stock
The first calculation summarizes quantity in stock. Only available stock is summarized, i.e., parts that are not
reserved, not damaged etc. Only the location types Production Line, Picking
Location and Floor Stock are considered.
- Calculation 2: Available open supplies
The second calculation finds out how much open supply that is available up to and including the Supply
Date of the current interim order by deducting the summarized demands with due dates not later than
the interim order Supply Date from the summarized supplies with due dates not later than the
interim order Supply Date. The Include Only Firm Demands and Include
Only Firm Supplies settings impact which types of demands respectively which types of supplies to
include in the calculation:
- Include Only Firm Demands: If Include Only Firm Demands is enabled,
only firm types of demands are included in the calculation. Else the setting is disabled and all types of
demands are included in the calculation.
- Include Only Firm Supplies: If Include Only Firm Supplies is enabled,
only firm types of supplies are included in the calculation. Else the setting is disabled and all types of
supplies are included in the calculation.
When demands are summarized, the netting algorithm makes sure the reserved quantities are excluded since
Calculation 1 deducts parts that are reserved.
- Calculation 3: Lowest ATP
The third calculation calculates the lowest ATP (available to promise) beyond the Supply Date
but within the cumulative lead time for manufactured parts and within the expected lead time for purchased parts.
This ATP calculation is calculated as a compensated standard cumulative ATP. Supplies and demands beyond these
cumulative/expected lead times are not considered since beyond these lead times, the availability is regarded as
infinite. The calculation of the cumulative lead time is done using the manufacturing calendar while the
calculation of the expected lead time is done without using any calendar. The Include Only Firm
Demands and Include Only Firm Supplies settings impact which types of demands
respectively which types of supplies to include in the calculation in the same way as described for Calculation
2.
Note: In case the source line is connected to a project activity, an interim order belonging to the topmost
interim order header in the structure can be project planned. The topmost interim order is always project planned
and for the other interim orders it depends on the supply code of the source line and the Create Pegged
Orders at Release and the Std Planned Item settings. An interim order cannot be project
planned unless the parent interim order also is project planned. When the supply code is DOP
Order, an interim order with a project planned parent interim order is also project planned if
Create Pegged Orders at Release is set to Yes and/or if Std Planned
Item is set to No. When the supply code is not DOP Order, an interim
order with a project planned parent interim order is also project planned if Std Planned Item is
set to No. A project planned interim order will be supplied from stock and supplies connected to
the same project activity as the source line is connected to. During the three calculations above, only stock,
supplies and demands which are connected to that same project activity are considered. If the project has
Material Allocation set to Within Project, also stock connected to other
activities for the same project are considered in the first calculation. For an interim order that is not project
planned, only stock, supplies and demands which are not connected to any project activity are considered during the
three calculations. Interim orders belonging to another interim order header than the topmost are never project
planned.
- Netted Qty = Lowest {Available Stock + Open Supplies, Supply Qty}
However, driving the projected quantity negative within the cumulative lead time for manufactured parts and
within the expected lead time for purchased parts is not allowed. Therefore, the lowest ATP, which is calculated in
calculation 3 is of high importance. If the lowest ATP is equal to zero or less than zero, it won’t be
possible to net any quantity at all. Else if the lowest ATP is less than the sum of available stock and open
supplies, it is not possible to net a bigger quantity than the lowest ATP. Else it will be possible to net the sum
of available stock and open supplies. Consequently, if the netted quantity is bigger than the lowest ATP, the
netted quantity is adjusted according to the following formulas:
If Lowest ATP ≤ 0, use formula:
Else if Lowest ATP < Netted Qty use formula:
The Net Qty, which is the quantity that remains to be supplied for the interim order after
netting from existing stock and open supplies, is finally set according to the following formula:
- Net Qty = Supply Qty - Netted Qty
Example:

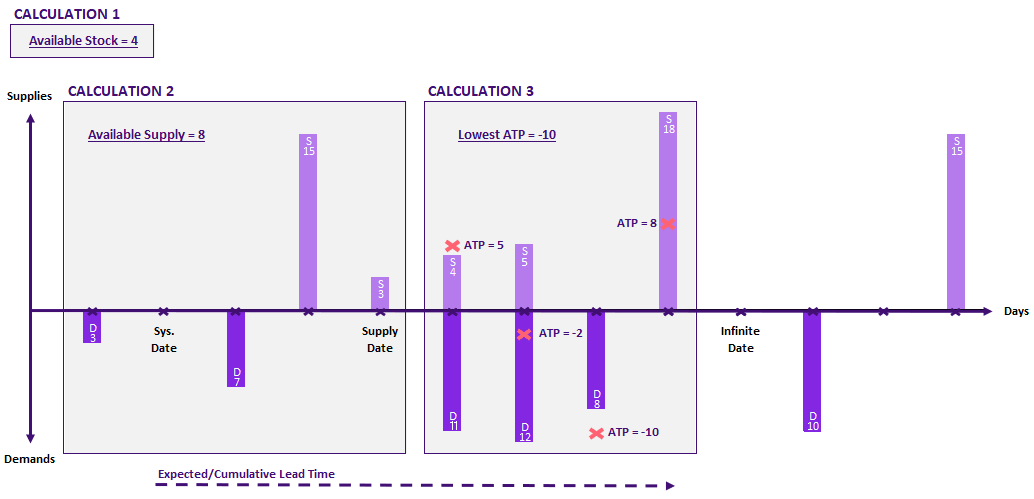

Assume that an interim order with Supply Qty equal to 10 should be netted and that the
expected/cumulative lead time for that interim order part is 6 days. In the picture below, calculation 1 gives the
result that the available stock is 4. In calculation 2, the summarized supply up until the Supply
Date minus the summarized demands up until the Supply Date results in available open
supplies up until the Supply Date equal to 8. This means that the incoming balance is 12 on the
Supply Date. That is used in calculation 3, that results in -10, when the lowest ATP beyond the
Supply Date but within the cumulative/expected lead time is found after calculating the ATP for
each day within the period.

When using the first formula for calculating the net quantity without considering driving the projected quantity
negative the result is 10. See formula:
- Netted Qty = Lowest {Available Stock + Open Supplies, Supply Qty} = Lowest {4 + 8, 10} = 10
However, the netted quantity must be adjusted to avoid driving the projected quantity negative. Since the lowest
ATP is less than zero, the netted quantity is adjusted to zero. See formula:
This means that the Net Qty will be equal to 10. See formula:
- Net Qty = Supply Qty - Netted Qty = 10
– 0 = 0

After the netting procedure, during the first planning step in the capability check, reservations and
allocations are done for each interim order in the interim order structure with Promise Planned
set to Promised. Reservations and allocations are also done before the fourth planning step
ends.
Reservations and allocations are done depending on the Reservation and Allocation Options
principle that is used.
-
Reserve and Allocate:
- Available stock which were netted to interim orders for parts for which pegged supply orders will be
created when the customer order is released are reserved to the interim orders. These interim orders have
Create Pegged Orders at Release set to Yes.
Note: Reservations can only be done for interim orders when the supply code of the source line is DOP
Order. Reservation of an interim order belonging to another interim header than the topmost interim
order header are only possible when the sales part connected to the inventory part on the topmost interim
order for that specific header has sourcing option DOP Order.
- Allocation for available stock and open supplies are done by creating interim order demand for the
Supply Qty of the interim order in the supply/demand view. When the available stock and open
supplies are not sufficient, interim order supply is created for the Net Qty of the interim
order. The Net Qty is the quantity which remains to be supplied after netting from existing
stock and open supplies. The created interim order demand and supply restrict other interim orders, in this and
future capability checks, to net from the same available stock and open supplies within the part expected or
cumulative lead time.
-
Allocate only:
- Parts available in stock are not reserved to the interim order.
- Allocation for available stock and open supplies are done in the same way as described for
Reserve and Allocate.
-
Neither Reserve nor Allocate:
- Parts available in stock are not reserved to the interim order.
- Allocation for available stock and open supplies are done in the same way as described for
Reserve and Allocate. However, this allocation is only temporary within this specific
capability check. The created interim order supply and demand will be discarded in the last phase of the
capability check when the outcome is saved. This means that the interim order demand and supply only restrict
other interim orders in this capability check to net from the same available stock and open supplies within
the part expected or cumulative lead time. Interim orders in future capability checks can net from the same
stock and open supplies.
Note: In case the source line is connected to a project activity, an interim order belonging to the topmost
interim order header in the structure can be project planned. The topmost interim order is always project planned
and for the other interim orders it depends on the supply code of the source line and the Create Pegged
Orders at Release setting and the Std Planned Item setting defined in the BOM. An interim
order cannot be project planned unless the parent interim order also is project planned. When the supply code is
DOP Order, an interim order with a project planned parent interim order is also project planned if
Create Pegged Orders at Release is set to Yes and/or if Std Planned
Item is set to No. When the supply code is not DOP Order, an interim
order with a project planned parent interim order is also project planned if Std Planned Item is
set to No. A project planned interim order will be supplied from stock and supplies connected to
the same project activity as the source line is connected to. For a project planned interim order, reservations
will only be done from stock connected to the same project activity as the source line is connected to. In
addition, the interim order demand and supply which are created to allocate available stock and open supplies will
be connected to that same project activity. If the project has Material Allocation set to
Within Project, also stock connected to other activities for the same project can be reserved. For
an interim order that is not project planned, reservations will only be done from stock which are not connected to
any project activity and the created interim order demand and supply will not be connected to any project activity.
Interim orders belonging to another interim order header than the topmost are never project planned.

In the planning phase the interim orders in the interim order structure are planned. The first, third and fourth
planning steps are done using backwards planning while the second planning step uses forwards planning. When
backwards planning an interim order, the Scheduled Supply Date is known, and the Scheduled
Start Date is calculated. When forwards planning an interim order, the Scheduled Start
Date is known, and the Scheduled Supply Date is calculated. The Scheduled Start
Date in backwards planning and the Scheduled Supply Date in forwards planning are
calculated in different ways depending on whether the interim order part is purchased externally, purchased
internally and delivered from supply site to demand site, purchased internally and delivered from supply site
directly to customer or manufactured. When the part is manufactured also the site setting Schedule and
Create Load for Interim Order Operations and the work center and labor class settings Finite
Capacity are of importance.
If the inventory part on the interim order is:
- Purchased externally:
- The Purchasing Lead Time defined for the inventory part is used.
- Neither the manufacturing nor distribution calendars are considered (i.e., activities can take place on
weekends). However, if the calculated date ends up on a non-working day according to the site distribution
calendar it is adjusted to the nearest working day.
- Purchased internally and delivered from supply site to demand site:
- The total lead time given from the site to site parameters Picking Lead Time, External
Transport Lead Time, Transport Lead Time and Internal Transport Lead
Time defined between the supply site and the demand site and the Inspection Lead
Time defined on supplier for the purchased part is used.
- If the calculated date ends up on a non-working day according to the site distribution calendar it is adjusted
to the nearest working day.
- Purchased internally and delivered from supply site directly to customer:
- The total lead time given from the site to customer parameters Picking Lead Time and
External Transport Lead Time defined between the supply site and the customer ordering the
demanded part is used.
- Manufactured and Schedule and Create Load for Interim Order Operations is disabled:
- The fixed and variable lead times are first calculated for the operations of the interim order and then used
together with the Net Quantity plus planned scrap of the interim order.
- The site manufacturing calendar is considered (i.e., activities only take place on workdays).
- Manufactured and Schedule and Create Load for Interim Order Operations is enabled:
- Each interim order operation is scheduled similar to how a shop order operation is scheduled. If the work
center and/or labor class of the operation has Finite Capacity enabled, operations will be
scheduled according to the remaining capacity for each day after subtracting already existing load. For more
details see Scheduling Interim Order Operations.
- The site manufacturing calendar and work center calendars are considered (i.e., activities only take place on
workdays). The calculated date is always a working day according to the site manufacturing calendar.

During all four planning steps in the capability check, interim order operations are scheduled when
Schedule and Create Load for Interim Order Operations is enabled for the site. The scheduling is
done backwards in the first, third and fourth planning steps and forwards in the second planning step.
At the same time as an operation is scheduled, work center and/or labor load is created. The scheduling works
similar to how a shop order operation is scheduled, but can also consider the remaining work center and/or labor
capacity for each day in order to schedule finite. Whether finite or infinite scheduling is performed is depending
on the Finite Capacity settings for the work center, setup labor class and runtime labor class of
the operation. When Finite Capacity is enabled the operation will be scheduled according to the
remaining capacity for each day after subtracting already existing load. No new overload will be created on
individual days and the total load during the scheduled period of the interim order will not be higher than the
total available capacity during the same period.
Example 1: Backwards scheduling at finite work center with infinite labor class
In this example an interim order operation is backwards scheduled at a work center with Finite
Capacity enabled. The labor class of the operation, which is the same for both setup and runtime, has
Finite Capacity disabled. The operation has 2 hours machine setup time, 4 hours labor setup time,
20 hours machine run time and 40 hours labor run time. The available capacity of the work center is 8 hours each
day and the available capacity of the labor class is 16 hours each day.

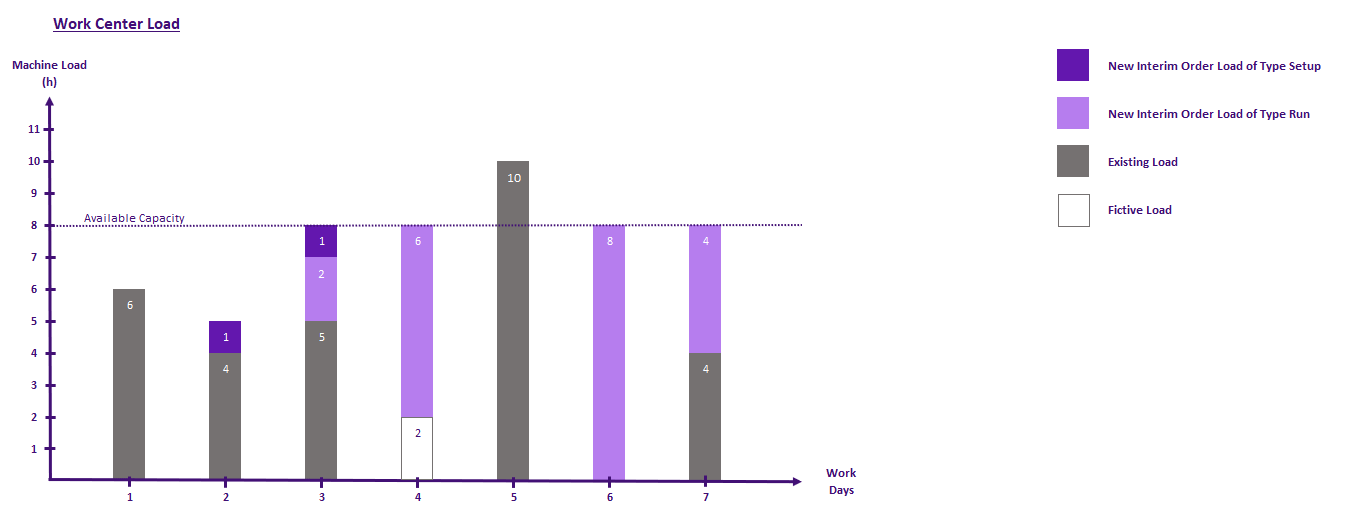

The charts below visualize how work center load is created and scheduled during backwards scheduling from the
Scheduled Finish Date at 5:00 PM day 7. Since Finite Capacity only is enabled for
the work center, the scheduling is performed according to the remaining work center capacity for each day after
subtracting already existing load. Remaining labor class capacity is not considered. The fictive load in the work
center load graph illustrates how the already existing overload at day 5 is fictively distributed to an earlier
working day, to avoid that the total load gets bigger than the total available capacity during the scheduled period
of the interim order operation. If forwards scheduling would have been performed, the existing overload at day 5
would have been fictively distributed to a later working day instead of an earlier. The result of the backwards
scheduling is that the Scheduled Start Date of the operation is set to 4:00 PM at day 2. The
preceding interim order operation will get a Scheduled Finish Date set to 4:00 PM at day 2, or
earlier.

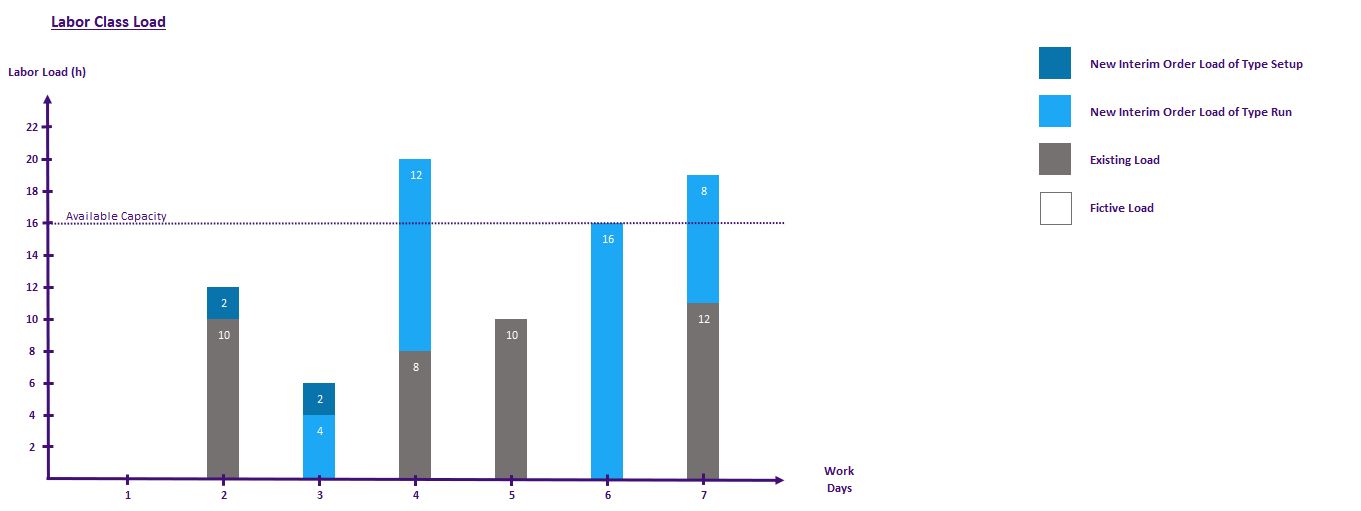

During the backwards scheduling load is also created and scheduled for the labor class. Since Finite
Capacity is disabled for the labor class, the labor load is scheduled according to when the machine load
was scheduled, without consideration of the remaining labor capacity for each day. How the labor load is created
and scheduled is visualized in the charts below.

Example 2: Backwards scheduling at finite work center with finite labor class
In this example an interim order operation is backwards scheduled at a work center with Finite
Capacity, similar to previous example, but this time also the labor class of the operation, that is the
same for both setup and runtime, has Finite Capacity enabled. The operation has 2 hours machine
setup time, 4 hours labor setup time, 20 hours machine run time and 40 hours labor run time. The available capacity
of the work center is 8 hours each day and the available capacity of the labor class is 16 hours each day.
The charts below visualize how both work center and labor load are created and scheduled for the operation

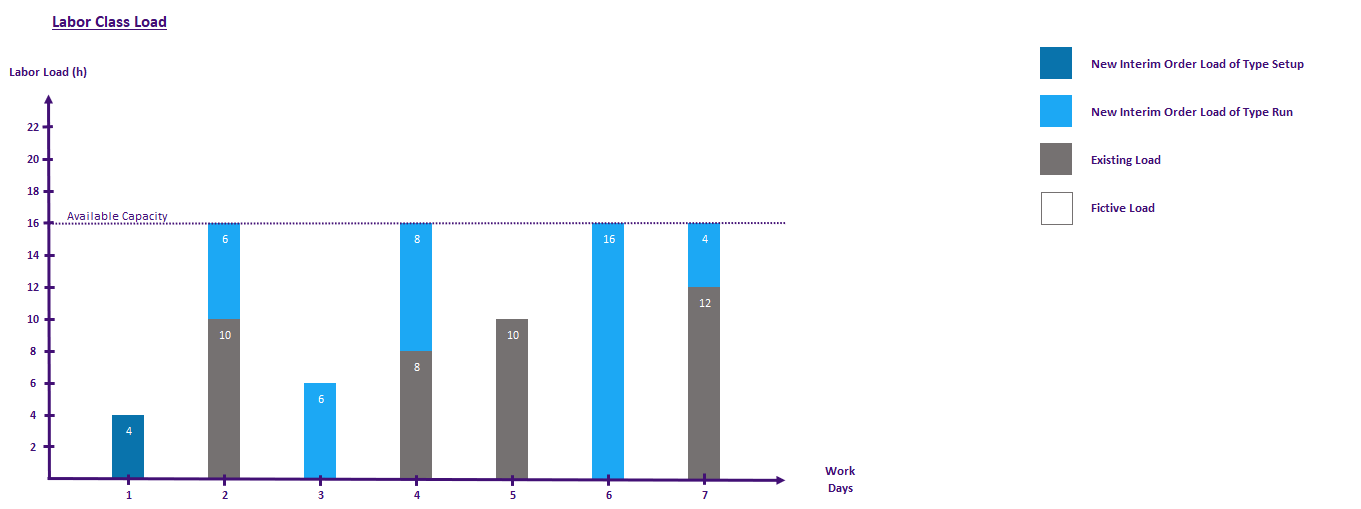

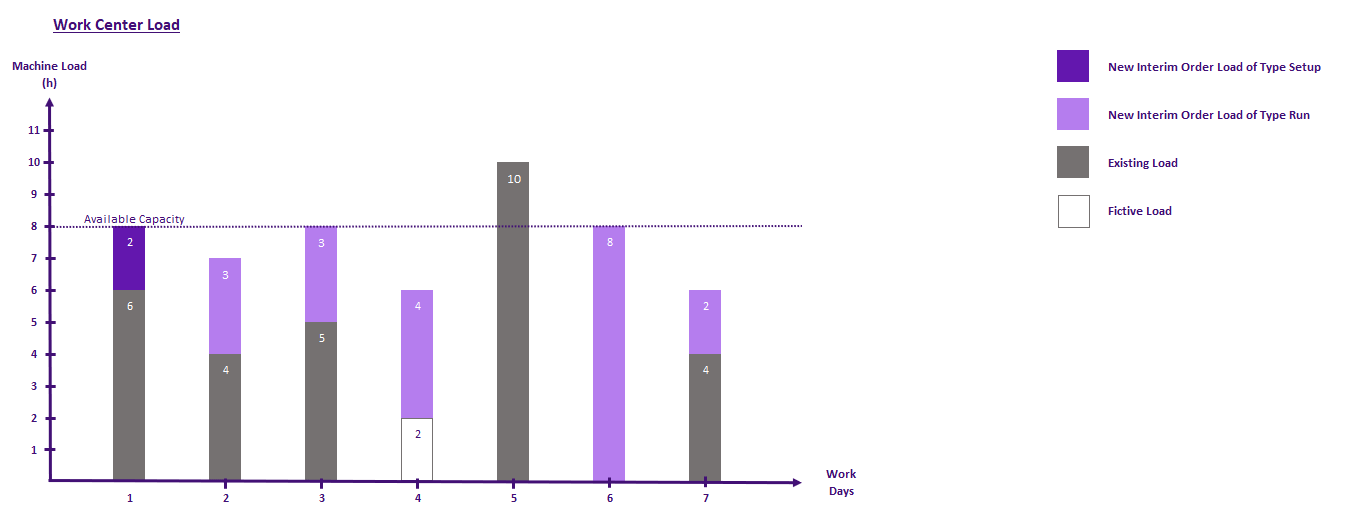

during backwards scheduling from the Scheduled Finish Date at 5:00 PM day 7. Since Finite
Capacity is enabled both for the work center and the labor class, it is not enough to only schedule
according to the remaining work center capacity for each day after subtracting already existing load. For each day
when there is remaining work center capacity, also the remaining labor class capacity for the day after subtracting
already existing load must be considered. By comparing the work center load graph with the labor class load graph,
you can see whether the remaining work center or labor class was the limiting factor for each day. E.g., at day 7
the remaining work center capacity was 4, but only 2 machine hours could be scheduled at that day because of the
limiting remaining labor class capacity that was only 4 hours. The result of the backwards scheduling is that the
Scheduled Start Date of the operation is set to 3:00 PM at day 1, one day earlier than in previous
example. The preceding interim order operation will get a Scheduled Finish Date set to 3:00 PM at
day 1, or earlier.

Schedule using Advanced Planning Board (APB)
When the capability check calculation has been completed, and a Reservation and Allocation
Options was used that saved the interim structure, the interim order operations can be scheduled using
IFS/Advanced Planning Board (APB). This allows more advanced scheduling considering finite machine, labor and tool
capacity as well as material constraints. When the APB schedule is saved back, the Scheduled Start
Date and Scheduled Supply Date of the affected interim orders are updated as well as the
Planned Due Date of the source line.
View the Result of a Capability Check
You can analyze the result of a capability check on the Capability Check Result page
where the interim order information that was saved during the saving outcome phase of the capability check
algorithm is displayed. For more information, see activity Analyze Capability Check Result.
When the capability check has been performed with Reservation and Allocation Options set to
Reserve and Allocate or Allocate only, and the interim orders have been scheduled
(using either APB, or having Schedule and Create Load for Interim Order Operations enabled for the
site), the estimated workload is saved. This load appears as Promised or Promised Interim
Order and can be analyzed using the Visual Capacity Requirements Planning
page.
Note that the load from an interim order operation may be distributed into several segments over multiple days
according to the remaining capacity for each day when finite loading has been enabled for the work center or labor
class.
Edit a Capability Checked Line
If you change any of the fields that have effects on the dates before the customer order is released or sales
quotation line is either lost or converted to customer order, the system will remove the value in the
Latest Release Date field, clear the Capability Check indicator and delete the
interim structure. Also reservations, allocations and load that potentially were created during the capability
check are removed. If the automatic capability check is activated, the system will start a new capability check
automatically. The same happens if you change the supply code or the sales quantity.
Create a Customer Order from a Capability Checked Sales Quotation Line
If you create a customer order from a capability checked sales quotation line, the result of the capability
check is transferred to the new customer order line. If the customer order is created in the
Released status the system behaves as described in Release a Capability Checked Customer Order.
You cannot release a customer order when the Latest Release Date is in the past. The order will
remain in status Planned. Instead, you should do a new capability check.
When a capability checked customer order is released and the capability check was performed with
Reservation and Allocation Options set to Neither Reserve nor Allocate, the
system behaves similar as if no capability check was performed.
If the capability check was performed with Reservation and Allocation Options set to
Reserve and Allocate or Allocate only, the interim order structure is deleted
when the customer order is released. The supply code will impact the behavior as follows:
- DOP Order: First, a DOP structure is created according to the interim order structure. This
means DOP orders are created for the parts with Default Supply Type set to DOP,
as well as for the levels below them in the BOM. The dates on the DOP orders are set according to the dates on
the interim orders. If the interim order operations are scheduled, due to the site setting Schedule and
Create Load for Interim Order Operations being enabled, the dates on the DOP order operations are set
according to the dates on the interim order operations. For parts with Default Supply Type set
to DOP and Promise Planned set to Not Promised, the DOP
structure and dates are created as per standard logic since no interim structure exists for such parts.
Reservations are then transferred from the interim orders to the DOP orders. If reservations exist on the top
level, these will be delivered directly to the customer order line. Next, DOP orders are netted from both
inventory and open supply orders. However, for parts with Promise Planned set to
Promised, the system will never net more than the quantity netted on the interim order.
Finally, the DOP orders are released which create shop orders for the remaining quantity to supply for
manufactured parts, and purchase orders for purchased parts. Note that the purchase requisition step is bypassed.
When a purchase order line for an internally purchased part is created, also an internal customer order line at
the supply site and a distribution order which links the purchase order line and customer order line together are
created. Both the internal purchase order and the internal customer order will be released automatically. The
supply code of the internal customer order line is set according to the sourcing option of the sales part. When
an internal customer order line with supply code DOP Order automatically is created and
released, a DOP structure is created according to the interim order structure, netted and released at the supply
site in a similar way as the DOP structure at the demand site. Also, reservations are transferred from the
interim orders to the DOP orders.
- Shop Order: A pegged shop order is created for the topmost part in a similar way as if no
capability check was performed. No pegged orders are created for the components since they are expected to be
planned by other mechanisms such as MRP.
- Int Purch Trans/Int Purch Dir: A pegged internal purchase order line is
created for the topmost part at the demand site in a similar way as if no capability check was performed. When
the system creates an internal customer order line on the primary supply site, a capability check is
automatically performed for the line if the inventory part linked to the sales part on this site has been setup
for an automatic capability check. This is recommended since else allocations and load will be lost when the
customer order on the demand site is released.
Limitations
- For source lines with supply code Invent Order only Neither Reserve nor
Allocate can be selected as Reservation and Allocation Options meaning another
capability check could net from the same material, and schedule using the same available capacity since no
allocations are created and no load is saved.
- In order to run capability check, the parts in the BOM must have phased in part revisions and manufactured
parts must have buildable structures and routings at certain dates within the time interval the capability check
algorithm uses. Note that these dates in some cases can be earlier than today's date. The parts cannot be
serial effective.
- The same structure and routing revisions which are used when building the interim order structure will be
used also during the planning phase of the capability check even though the interim orders might be moved to
other dates when the structure and routing revisions are not valid.
- If capability check runs with supply code set to Int Purch Dir, the topmost interim order in
the structure, that is created at the demand site, is purchased internally and delivered from the supply site
directly to the customer. When this interim order is planned no delivery route that might have been defined
between the supply site and the customer ordering the demanded part is considered. That means capability check
can plan the topmost interim order to be shipped at a day that is not a delivery day according to the defined
route.
- MRP (or project MRP) cannot create any allocations for parts with planning methods B,
C and N since those are not processed by the MRP. For interim orders with those
parts which are deleted in the current capability check, this means that it is not possible to prevent future
capability checks to net from the same stock and open supplies as already used by those deleted interim orders by
running MRP after the current capability check is done. It is also not possible to prevent future capability
checks to use the same capacity as already used by those deleted interim orders by running a CRP integrated with
the MRP.
- When you run capability check for a source line with Include Only Firm Demands disabled, it
is recommended to not have run MRP before running the capability check. If so, MRP can have created non-firm
demands of type MRP Planned Demand according to the source line demand. These demands allocate
available stock and open supplies for MRP planned parts in the product structure, and can prevent the capability
check from netting available stock and open supplies which would have been possible to net otherwise.
- When you run capability check for a source line with Include Only Firm Demands disabled, all
MRP planned demands will be considered during the netting, including MRP planned demands originating from master
schedule forecast demands. The MRP planned demands which originates from master schedule forecast demands may be
consumed by the demand from the source line once master scheduling and MRP runs. If capability check runs for the
source line, before master scheduling and MRP, these demands will still remain and may prevent the capability
check from netting available stock and open supplies which would have been possible to net otherwise. There is no
way to distinguish which MRP planned demands that originates from master schedule forecasts demands and hence, it
is not possible to exclude them during the capability check netting.
- If you run capability check with Schedule and Create Load for Interim Order Operations
enabled, connections between child interim orders and operations on parent interim orders are only considered
when the interim order structure is backwards planned in the first, third and fourth planning steps. During the
second planning step, when a possible completion date is calculated by forwards planning the interim order
structure, operation connections are not considered. As result, the possible completion date may be later than it
would have been if the operation connections had been taken into account. If it is important to consider
operation connections when generating the new delivery date that is calculated if the requested delivery date is
not possible to fulfill, it is recommended to enable Optimize New Delivery Date.
- The new delivery date that is calculated if the requested delivery date is not possible to fulfill and
Optimize New Delivery Date is enabled, is not necessarily the earliest delivery date that is
possible to fulfill. It is only optimized by considering open supplies which become available for interim orders
when they are planned with later Scheduled Supply Dates. It is not possible to optimize the
delivery date by calculating the optimal quantity to net on each interim order when the same part exists on
several interim orders in the structure or by calculating the optimal order the interim order operations should
be scheduled in when work center and labor class capacity is finite.
- When releasing a capability checked customer order line with saved interim structure and supply code set to
DOP Order, the DOP order dates are inherited from the interim orders. If a DOP order nets a
lower quantity than the interim order, the DOP order start date may be later than required given the higher DOP
order quantity. Hence, supplying DOP orders may be planned too late to meet the shop order material demand.
- The Use Std Inventory In Project MRP/Project MS setting on Project
Definition/Site tab is not affecting the capability check algorithm.
