Activity duration estimate exampleΒΆ
A simple example of using an activity duration estimate is outlined below.

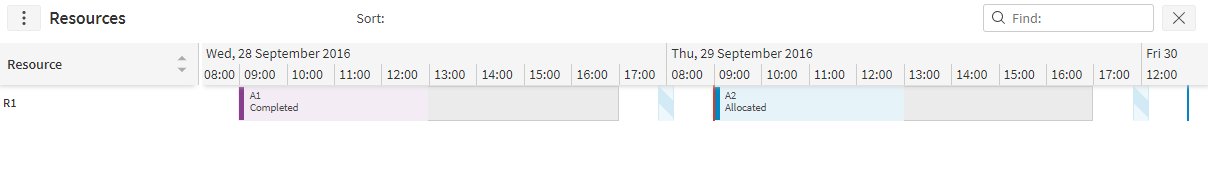

An activity of activity type 'type1' is sent to the DSE to be scheduled with duration set to 8 hours and not requesting to use auto-duration (auto_duration_enabled=false). The activity gets scheduled by the DSE on the first day of his two shifts at 9am, expected to take 8 hours to complete. See below screenshot of activity on-site at 9am on the first day:

Later on in the first day, at midday, the activity is actually completed early - 4 hours after it has started:

Once the Archiving service has processed a snapshot of this scheduling data, it analyses the activities and estimates that the good duration estimate for this type of activities (type1), is 4 hours and adds a record (or updates if it exists previously) to the Activity_Duration_Estimate table for this grouping of activities (of activity type 'type1') with column values:

On the next day, when a new activity of the type ('type1') is sent to the DSE to be scheduled - this time asking for an auto duration, if it exists (auto_duration_enable=true). The Input Manager recognises that there is an activity duration estimate for this activity of 4 hours, and sets the auto_duration to this. The auto_duration is used in turn by DSE to schedule the activity:

If the activity had not requested for an auto duration, the activity would be scheduled with a duration of 8 hours:

Note
Obviously, this is a trivial use of activity duration estimate and it is only added to illustrate the activity duration estimate/auto-duration functionality. The 'MinimumNumberOfSamplesForActivityDurationEstimate' is set to 1 in this example, so that Archiving Service makes an estimate for this activity with only one sample. Hence, the confidence level is 100, which is due to the fact that the mean value of one activity's actual duration is the duration of the single activity. It is recommended that the parameter is set to at least 10 samples before the Archiving Service is allowed to estimate activity durations for any grouping of activities (activity type/customer/contract/location combinations).
